The Complete Factory Setup Playbook for Northeast India MSMEs
14 Approvals, 6 Departments, And A Whole Bunch Of Checklists: Included
0 of 8 sections read
Every year, MSME owners across Northeast India file for factory licenses, apply for bank loans, and stall. Not because the project is wrong. Not because the market is not there. Because the process of getting from DPR to production, 14 approvals, 6 departments, zero useful guides, is scattered across too many portals and too many contradictory pieces of advice.
This report maps the full sequence. DPR preparation (what bank appraisal officers actually score), the 14 regulatory approvals (in dependency order, with NE India-specific complications like Sixth Schedule land restrictions), the real cost of factory setup in Assam (line by line, including the Rs.5-15 lakh APDCL transformer deposit nobody budgets for), and the compliance obligations for your first 12 months of operations.
It is built for MSME owners, CAs, project consultants, and institutional officers who need a single reference document, not a government pamphlet, not a sales pitch, that maps what factory setup in NER actually costs, takes, and requires. The compliance obligation figure of 1,450+ comes from SME Futures (2026). Cost and timeline data is sourced from AIDC, APDCL, and Pollution Control Board Assam.
A Detailed Project Report is the single most important document an MSME produces before approaching a bank. And it is the document they prepare worst. Banks do not reject DPRs because the project is unviable. They reject them because the document does not speak the language appraisal officers read.
The RBI Master Direction on MSME Lending (updated February 2026) specifies exactly how banks must appraise MSME credit proposals. Know what the appraisal officer scores, and you get funded.
The Six Sections Every DPR Must Contain
| Section | What It Must Cover |
|---|---|
| 1. Promoter Profile | Qualifications, industry experience, track record. Banks assess promoter credibility before project credibility. |
| 2. Technical Feasibility | Product, process, technology, plant layout, raw materials, capacity. Proves you know what you are building. |
| 3. Market Analysis | Target market, demand projections, competition. Banks want confirmed demand, not generic industry stats. |
| 4. Financial Projections | Capital cost, means of finance, P and L, cash flow, balance sheet. 70% of appraisal time is spent here. |
| 5. Implementation Schedule | Month-by-month Gantt chart. Banks match this to the moratorium period on your loan repayment. |
| 6. Risk and Mitigation | Name the actual risks: raw material swings, monsoon logistics, power gaps. Then name the specific fix. |
The KVIC PMEGP DPR template is the closest thing to an official standard. It forces structured financials but lacks market analysis, risk assessment, and implementation timeline. Use it as your financial backbone, then add those three as separate annexures.
Key Financial Metrics Banks Evaluate
DSCR: Must be 1.5x or higher. Below 1.33x is typically an automatic reject.
Break-Even: Banks want it within 18-24 months. Month 36+ projections raise red flags.
Promoter Contribution: Minimum 20-25% equity. Under CGTMSE, collateral-free loans up to Rs.5 Cr are available for MSMEs with strong DPRs.
The Four Mistakes That Kill DPRs
Mistake 1: Hockey-stick revenue projections. Revenue doubling year-on-year with no justification. If you project Rs.3 Cr in Year 1 for a new unit, you need confirmed orders, not market size data.
Mistake 2: Understated working capital. Most DPRs understate working capital by 30-50%. This is the number one reason new manufacturing units fail within 24 months.
Mistake 3: Missing or generic risk section. Writing “market risk may impact sales” is not a risk assessment. Name raw material volatility, single-customer dependency, monsoon logistics in NER, Assam power supply gaps.
Mistake 4: No implementation schedule. A DPR without a month-by-month Gantt chart forces the bank to guess, and banks do not like guessing.
Most MSMEs discover approvals reactively, after a contractor asks for one or an inspector shows up. The sequence matters because some approvals gate others. Getting CTE wrong delays everything downstream by 3-6 months. Missing EPF registration blocks your subsidy applications.

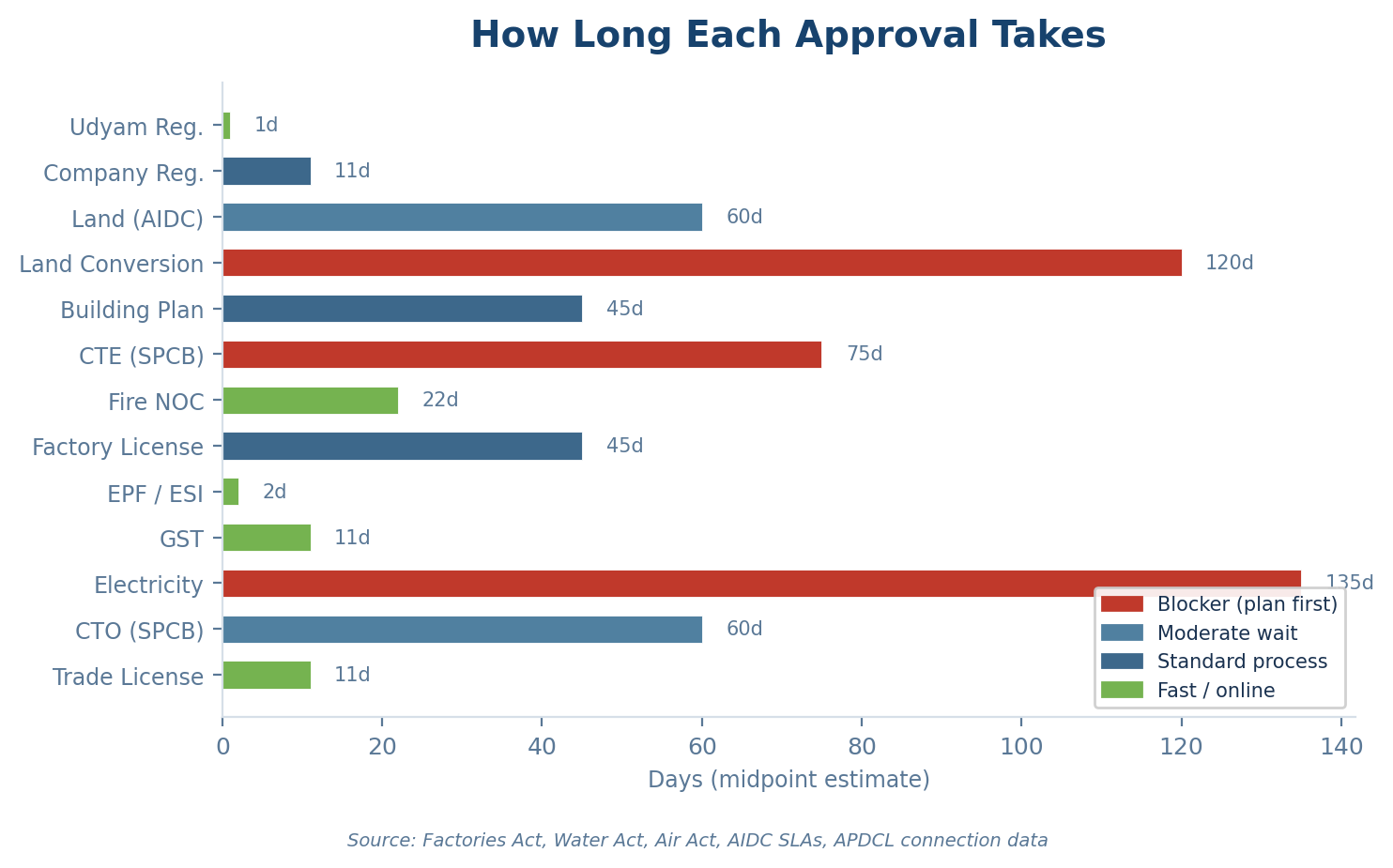

| # | Approval | Timeline | Authority | Cost |
|---|---|---|---|---|
| 1 | Udyam Registration | Instant | MSME Ministry | Free |
| 2 | Company/Firm Registration | 7-15 days | MCA / Registrar | Rs.1K-15K |
| 3 | Land (AIDC) | 30-90 days | Revenue / AIDC | Varies |
| 4 | Land Use Conversion | 60-180 days | Revenue Dept | Rs.5K-50K+ |
| 5 | Building Plan Approval | 30-60 days | Town Planning | 0.5-2% of cost |
| 6 | CTE | 30-120 days | PCB Assam | Rs.10K-2L |
| 7 | Fire Safety NOC | 15-30 days | Fire Services | Rs.2K-10K |
| 8 | Factory License | 30-60 days | CIF | Rs.1K-5K/yr |
| 9 | EPF Registration | 1-3 days | EPFO | Free |
| 10 | ESI Registration | 1-3 days | ESIC | Free |
| 11 | GST Registration | 7-15 days | GST Portal | Free |
| 12 | Electricity (APDCL) | 90-180 days | APDCL | Rs.5-15L deposit |
| 13 | CTO | 30-90 days | PCB Assam | Rs.10K-1.5L |
| 14 | Trade License | 7-15 days | Municipal/Panchayat | Rs.500-5K/yr |
Timelines compiled from the Factories Act 1948, Water and Air Acts, AIDC allotment SLAs, APDCL connection data, and the National Single Window System for Assam.
The Three Blockers
Three approvals block everything downstream if delayed. Land use conversion (#4): if your land is agricultural, nothing moves until this clears. CTE (#6): construction cannot legally begin without it. Electricity connection (#12): a 6-month wait that most MSMEs do not plan for. Plan for these three first. Everything else sequences around them.
Land is where most NER factory projects die quietly. The reason is not cost. Land in Assam is significantly cheaper than in Gujarat, Tamil Nadu, or Maharashtra. The reason is complexity: classification, conversion, and constitutional protections that do not exist in most other Indian states.
Sixth Schedule: Constitutional Protection for Tribal Land
The Sixth Schedule of the Indian Constitution (Articles 244(2) and 275(1)) provides autonomous governance to tribal areas in Assam, Meghalaya, Tripura, and Mizoram through Autonomous District Councils (ADCs). Under Paragraph 3, ADCs have exclusive legislative power over land tenure. Transfer of tribal or community land to non-tribals requires explicit ADC sanction and, in some cases, Governor approval.
In Assam, this applies to: Bodoland Territorial Council, Karbi Anglong Autonomous Council, and Dima Hasao Autonomous Council areas. Standard revenue department procedures may not apply. Non-tribal entrepreneurs must engage with the ADC directly.
In the plains of Assam (non-Sixth Schedule areas), land is classified under the Assam Land and Revenue Regulation, 1886. You cannot use agricultural land for manufacturing until you convert it to industrial use, a process that runs through the Revenue and Disaster Management Department, requires NOCs from multiple authorities, and takes 60-180 days.
The Three Land Options

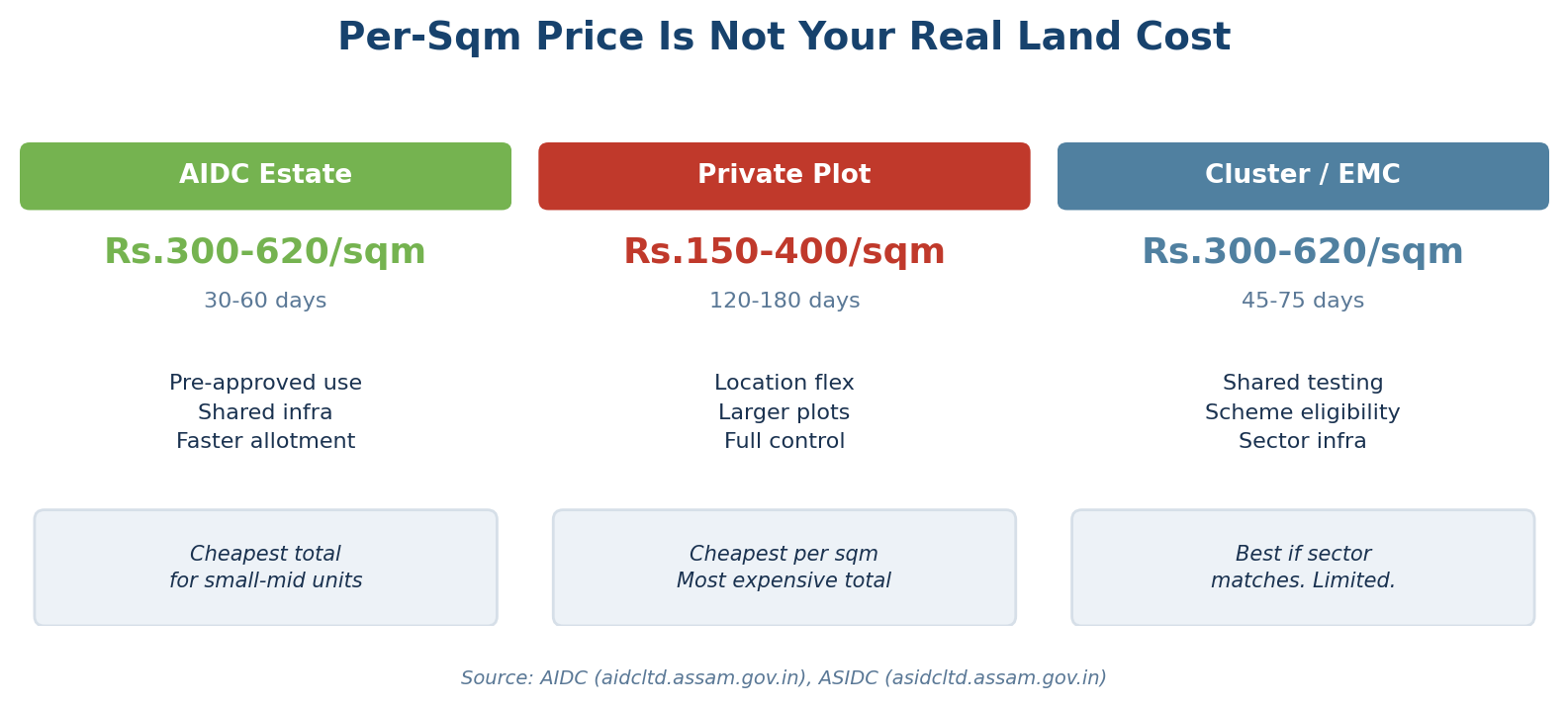

| Option | Cost per sqm | Timeline | Best For |
|---|---|---|---|
| AIDC Estate | Rs.150-620 | 30-60 days | First-time manufacturers, compliance simplicity |
| Private Plot | Rs.150-400 | 120-180 days | Larger units (Rs.5 Cr+), specific location needs |
| Cluster / EMC | Rs.300-620 | 45-75 days | Sector-specific MSMEs, cluster scheme benefits |
AIDC processing fee is Rs.50,000 for MSMEs and Rs.2,00,000 for large industry.
NER-Specific: Collateral and Land Title Constraints
In Sixth Schedule and hill areas, land is often held communally or under customary tenure without formal title deeds (patta). Land without a clear, transferable title cannot be used as collateral for bank loans. MSMEs in these areas should explore CGTMSE (collateral-free guarantee up to Rs.5 Cr) or consider industrial estate plots with clear lease documentation.
Everyone says “it depends.” This section gives the actual numbers. The model below is for a 5,000 sq ft light manufacturing unit (food processing, packaging, light assembly) in a non-metro Assam district, on an AIDC industrial estate plot.

| Cost Item | Range (Rs.) | Notes |
|---|---|---|
| Land (5,000 sqft at AIDC) | Rs.1.4-2.9L | AIDC rates: Rs.300-620/sqm. Plus Rs.50K processing fee. |
| Industrial shed construction | Rs.25-40L | Steel frame + RCC: Rs.500-800/sqft. |
| Boundary wall and compound | Rs.3-5L | Required for factory license and CTE compliance. |
| Approach road (private plots) | Rs.2-8L | AIDC estates include approach roads. |
| Electrical infrastructure | Rs.8-18L | Internal wiring, panels. Excludes APDCL. |
| APDCL connection + deposit | Rs.5-15L | Transformer security deposit. Wait: 3-6 months. |
| DG set (backup power) | Rs.3-8L | 62.5-125 KVA. Essential in Assam. |
| Water supply and borewell | Rs.1.5-3L | Piped supply unreliable outside Guwahati. |
| Effluent Treatment Plant | Rs.2-10L | Required for Orange/Red category (PCB Assam). |
| Fire safety infrastructure | Rs.1-2.5L | Extinguishers, hydrant points, signage. |
| Regulatory approvals (all) | Rs.1.5-3L | CTE, CTO, factory license, building plan, trade license. |
| Professional fees | Rs.1.5-3L | DPR, building design, environmental assessment. |
| Working capital (3 months) | Rs.10-25L | Most underestimated cost in the entire project. |

Total estimated range: Rs.65L to Rs.1.4Cr (excluding machinery). Of this, Rs.30-60L are items most MSMEs do not budget for. The APDCL transformer deposit alone runs Rs.5-15L.
What This Table Does Not Include
Machinery and equipment (project-specific), vehicles, furniture and fixtures, IT infrastructure, and pre-operative expenses. Add these for total project cost in your DPR. Machinery typically adds Rs.20L-2Cr+ depending on the manufacturing activity.
Manufacturing MSMEs in India face over 1,450 regulatory obligations annually, according to SME Futures (2026). For a new manufacturer in NER, the compliance clock starts ticking before the factory opens, and the penalties for missing a beat are specific, documented, and expensive.

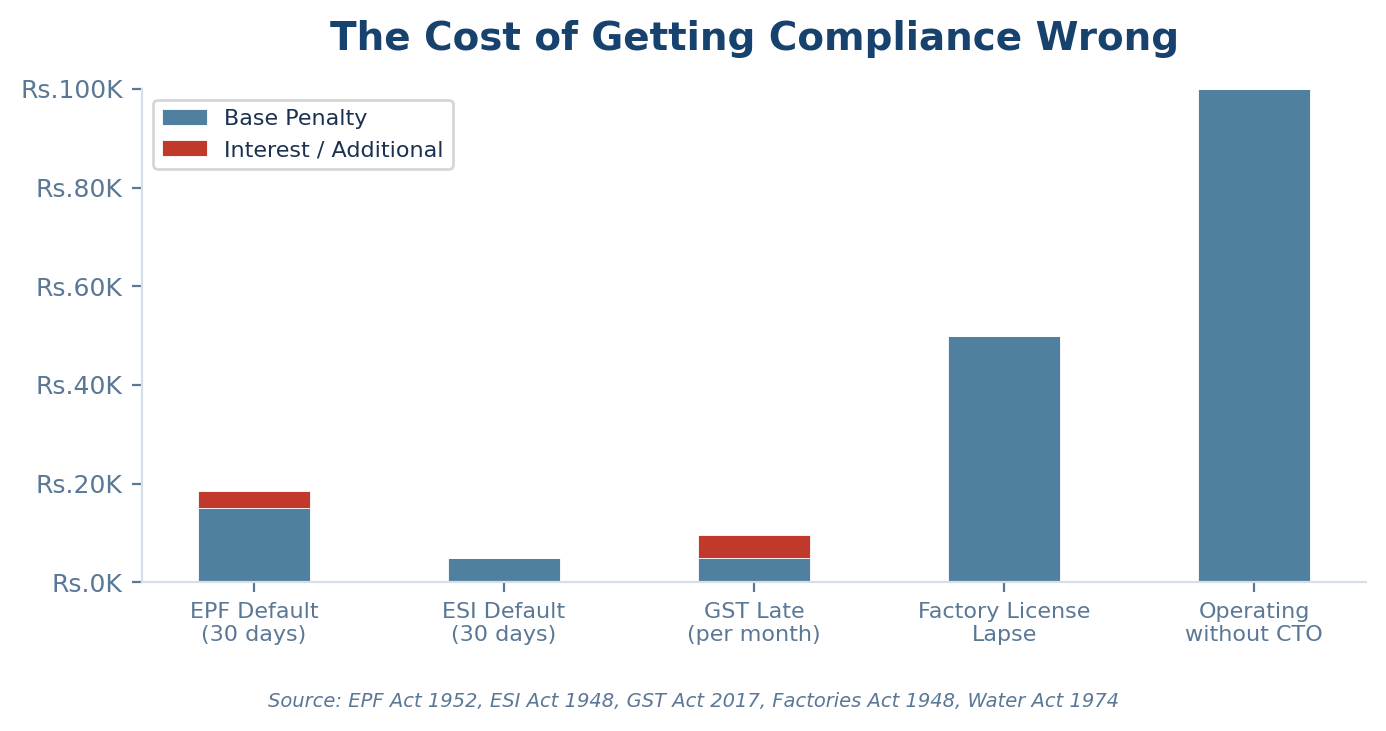

| Domain | Triggers At | Rate | Filing | Penalty |
|---|---|---|---|---|
| EPF | 20+ employees | 12% employer, 12% employee | Monthly (15th) | Rs.500/day + 12% p.a. |
| ESI | 10+ employees | 3.25% employer, 0.75% employee | Monthly (15th) | Fine up to Rs.5,000 |
| GST | All manufacturers | 5-28% by HSN | Monthly | Late fee + 18% interest |
| Factory License | 10+ workers (power) | Rs.1K-5K/yr | Annual | Closure + prosecution |
| SPCB (CTO) | All mfg (except White) | Rs.10K-1.5L | 2-5 year renewal | Closure direction |
| Professional Tax | All employers (Assam) | Rs.2,500/yr max | Monthly/Annual | Non-registration penalty |
Thresholds and penalties are defined in the EPF Act 1952, ESI Act 1948, Factories Act 1948, Water Act 1974, Air Act 1981, Assam Professional Tax Act 1947, and GST Act 2017.
You have the factory license. Production has started. You now owe 5 government departments something every single month.
| When | Compliance Obligations |
|---|---|
| Every Month | GST returns (GSTR-1 by 11th, GSTR-3B by 20th); EPF deposit (by 15th); ESI deposit (by 15th); TDS deposit (by 7th); Professional tax |
| Every Quarter | Advance tax (15th of Jun/Sep/Dec/Mar); GSTR-1 quarterly (QRMP); Labour welfare fund |
| Month 1-3 | Factory inspector visit prep; Occupational health records; Accident register; Waste disposal contract |
| Month 6 | Half-yearly SPCB report (Red/Orange); Review GST HSN codes; First internal safety audit |
| Month 9-12 | Factory license renewal; Annual return (Form 22); GSTR-9; ITR; Audited financials; CTO renewal planning |
Compliance Items MSMEs Discover Too Late
Hazardous waste authorization is required even for small quantities under the 2016 Rules. Factory canteen is mandatory at 250+ workers. Creche facility is mandatory at 30+ women employees. Annual labour return under the Assam Shops and Establishments Act is due January 31 each year.
Most MSMEs apply for government incentives before their compliance, registration, and documentation stack is complete, and then wonder why applications stall at Stage 1. Every major scheme requires the same 7 things. Most MSMEs have 3 of them when they apply.
| # | Prerequisite | What It Means |
|---|---|---|
| 1 | Udyam Registration | Active, correct NIC code, investment/turnover matching actuals. |
| 2 | Bankable DPR | DSCR 1.5x+, break-even within 24 months, working capital provisioned. |
| 3 | Land with Clear Title | Sale deed or AIDC lease. Sixth Schedule areas: ADC clearance documented. |
| 4 | All Pre-Operation Approvals | CTE, factory license, building plan, fire NOC. All current. |
| 5 | EPF and ESI with Actual Data | Employee data uploaded, monthly deposits current. Required for MSLI. |
| 6 | GST with Correct HSN Codes | Active registration, correct classification, regular filing history. |
| 7 | Audited Financials | Last 2-3 years audited, or CA-certified project cost estimate. |
This checklist works for every scheme: UNNATI (if extended), Assam Industrial Policy, NEIDS, PMEGP, CGTMSE, or any sector-specific programme. Get these 7 right once. Every application after that is paperwork, not a project.
Methodology
Cost estimates are based on AIDC published rates, APDCL tariff orders, contractor surveys in Assam (2024-2026), and Nitisagar Advisory primary research. Regulatory timelines are based on statutory provisions, official SLA commitments, and reported actual experience. State investment data from Advantage Assam. All figures should be verified against current rates before use in a DPR or business plan.
